Transforming stakeholder involvement from compliance exercise to competitive advantage
Open any research proposal and you’ll find a stakeholder section. Most feature an impressive list: industry partners, policy makers, patient groups, NGOs, SMEs, and more. Yet evaluators consistently cite weak stakeholder engagement as a major proposal weakness. The problem? Listing stakeholders is not a strategy.
True stakeholder engagement—the kind that strengthens proposals, improves research quality, and maximizes impact—requires systematic planning, genuine involvement, and demonstrable commitment. It’s the difference between checking a box and creating partnerships that transform how research is designed, executed, and applied.
This article explores how to develop stakeholder engagement strategies that evaluators find credible and that actually work throughout project lifecycles.
The Credibility Gap: Why Most Stakeholder Sections Fail
Evaluators read hundreds of proposals. They’ve developed keen instincts for distinguishing authentic engagement from window dressing. Here’s what triggers skepticism:
Red Flags for Evaluators:
-
“We will engage stakeholders through workshops and surveys” (vague, no specifics)
-
Long lists with no indication of who does what, when, or why
-
Stakeholder Advisory Board mentioned but no terms of reference, meeting frequency, or decision-making authority
-
No evidence of prior contact or established relationships
-
Generic descriptions applicable to any project
-
Stakeholders only appearing in dissemination phase, absent from co-design
-
No budget allocated for stakeholder activities
Behind these red flags lies a fundamental misunderstanding: stakeholder engagement is not about informing external parties about your brilliant research; it’s about involving them in ways that shape research to address real needs and ensure results are actually used.
The Fundamental Principle
Core Insight: Stakeholders are not your audience—they are your partners. The quality of engagement determines research relevance, adoption probability, and ultimately, impact. Evaluators assess whether your approach recognizes this reality.
From Mapping to Engagement: The Strategic Framework
Effective stakeholder engagement follows a progression from identification through sustained partnership. Let’s examine each stage:
Stage 1: Comprehensive Stakeholder Mapping
Begin by systematically identifying all parties with an interest in or influence over your research:
Stakeholder Categories
|
Category |
Examples | Primary Interest |
| End Users | Clinicians, farmers, teachers, engineers | Practical tools and methods they can apply |
| Beneficiaries | Patients, consumers, citizens, communities | Improved outcomes and quality of life |
| Decision Makers | Policy officials, hospital administrators, business executives | Evidence for policy/investment decisions |
| Funders | Government agencies, foundations, industry | Return on investment, strategic alignment |
| Regulators | Medical device authorities, environmental agencies | Safety, compliance, standardization |
| Industry | Companies that might commercialize results | Market opportunities, competitive advantage |
| Civil Society | Patient organizations, advocacy groups, NGOs | Representation of affected communities |
| Research Community | Academic peers, complementary research groups | Scientific advancement, collaboration |
For each stakeholder group, document:
- Specific interest: What do they care about in your project?
- Influence level: Can they affect project success or adoption?
- Potential contribution: What expertise, resources, or access can they provide?
- Engagement needs: What level of involvement is appropriate?
Stage 2: Prioritization and Strategy Selection

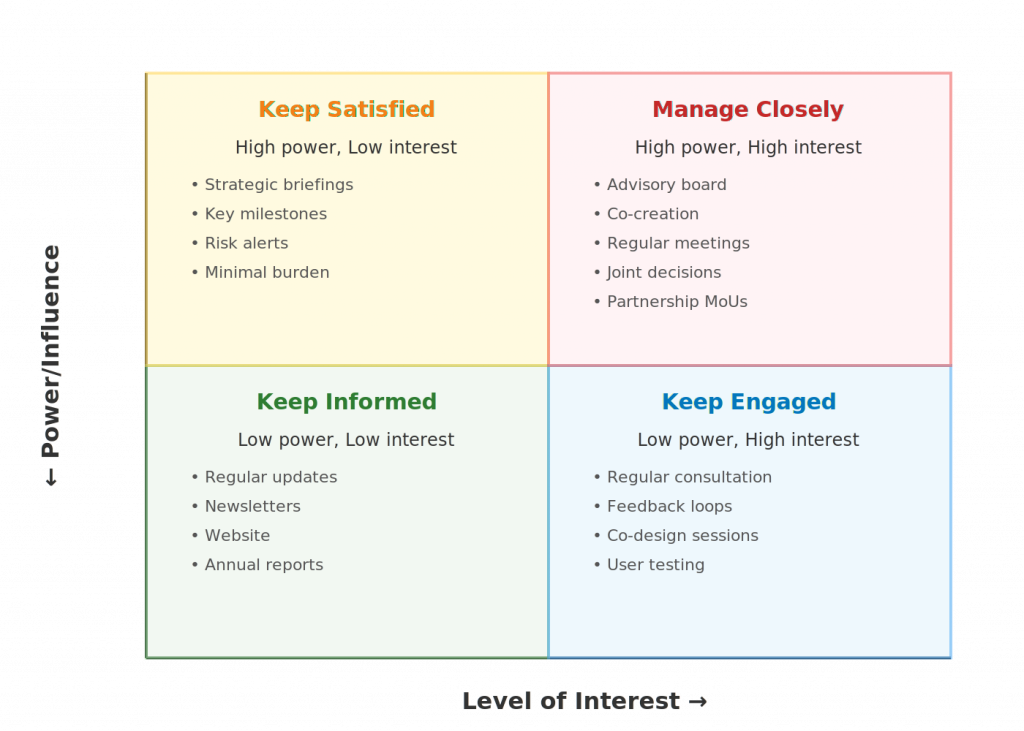

Not all stakeholders require the same engagement intensity. The classic power-interest matrix helps prioritize:

Strategic Application:
- Manage Closely (High Power, High Interest): Core partners deserving intensive engagement—Advisory Board members, consortium partners, key industry collaborators, major beneficiary representatives
- Keep Satisfied (High Power, Low Interest): Influencers who can affect project success but have limited bandwidth—regulatory authorities, senior policy officials, institutional leadership
- Keep Engaged (Low Power, High Interest): Enthusiastic supporters valuable for co-design and testing—end user groups, early adopters, professional associations, specialized communities
- Keep Informed (Low Power, Low Interest): Broader community requiring awareness but not deep involvement—general public, peripheral organizations, distant collaborators
Stage 3: Engagement Method Selection

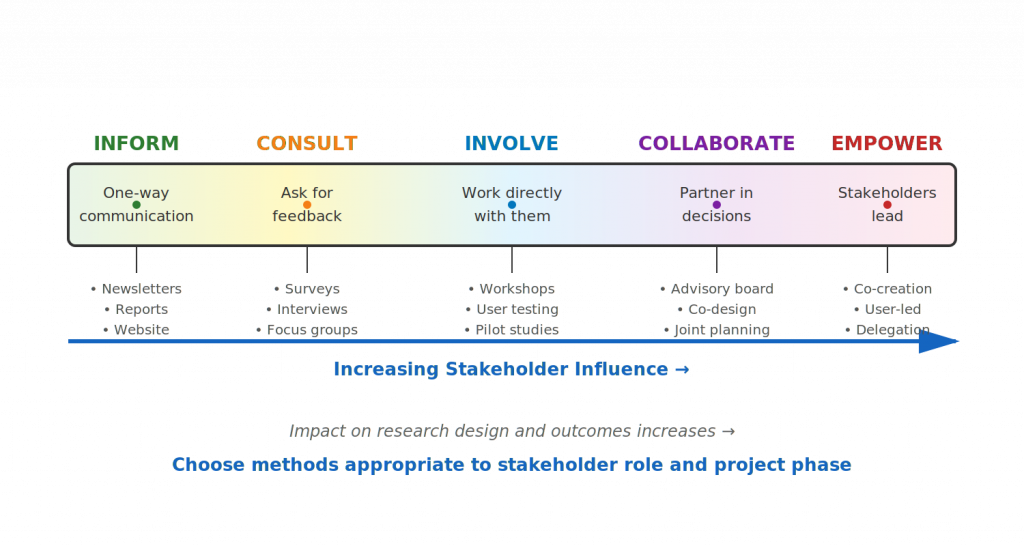

Match engagement methods to stakeholder needs and project phases:

Critical Insight: Different stakeholders may sit at different points on this spectrum simultaneously. Your Advisory Board operates at “Collaborate” level while broader professional community receives “Inform” level engagement. The strategy is in making these choices deliberately and explaining the rationale.
Timing Matters: Engagement Across Project Phases
Credible engagement strategies specify when stakeholders are involved, not just that they will be involved:
Pre-Proposal Phase (Often Forgotten!)
The strongest proposals demonstrate stakeholder involvement before submission:
- Letters of support from end users confirming problem relevance
- Industry partner commitment to co-funding or in-kind contributions
- Patient organization input on research priorities
- Preliminary user needs assessment
- Advisory Board members identified and committed
Evaluator Impact: Pre-proposal engagement provides powerful evidence that your project addresses real needs rather than academic curiosity.
Project Design Phase (Months 1-6)
- Formal establishment of Stakeholder Advisory Board with Terms of Reference
- User requirements workshops to refine specifications
- Baseline stakeholder assessment and needs analysis
- Co-design sessions for key project outputs
- Establishment of stakeholder communication channels
Implementation Phase (Ongoing)
- Regular Advisory Board meetings (typically quarterly) with documented outcomes
- Iterative user testing and feedback incorporation
- Stakeholder validation of interim results
- Pilot implementations with early adopters
- Periodic stakeholder surveys assessing satisfaction
Translation Phase (Final Year)
- Stakeholder workshops on implementation barriers and solutions
- Co-development of training materials and guidance
- Industry partner engagement on commercialization pathways
- Policy stakeholder briefings on recommendations
- End-user community building for sustainability
Post-Project Sustainability
- Transition of Advisory Board to permanent structure or network
- Handover of results to stakeholder organizations for continued use
- Stakeholder-led dissemination in their networks
- Alumni network maintenance for future collaboration
Making It Real: Specific Engagement Mechanisms
Move from abstract concepts to concrete mechanisms evaluators can visualize:
Stakeholder Advisory Boards (SABs)
Nearly every competitive proposal includes an SAB. Here’s how to make yours credible:
Elements of a Credible SAB:
- Specific composition: Name the organizations (and ideally individuals) who have committed
- Clear mandate: Define what decisions SAB influences vs. what is advisory only
- Terms of Reference: Document membership, meeting frequency, decision-making processes
- Meeting schedule: Specific timeline (e.g., Months 3, 9, 15, 21, 30, 36)
- Budget allocation: Travel costs, facilitation, documentation
- Output specification: Meeting minutes, annual recommendation reports
- Diversity: Balance of sectors, perspectives, geographies, demographics
Good Example: “Our Stakeholder Advisory Board comprises 12 members representing patient organizations (3), clinical practitioners (3), health system managers (2), payers (2), and regulators (2). Confirmed participants include [specific named organizations]. The SAB meets quarterly (Months 3, 9, 15, 21, 27, 33) via video conference with one annual in-person strategic session (Month 18, €15,000 budgeted). SAB provides input on user requirements (M3), validation of clinical protocol (M9), interim results assessment (M15, M21), implementation strategy (M27), and exploitation recommendations (M33).”
Bad Example: “We will establish a Stakeholder Advisory Board including representatives from relevant sectors who will be consulted regularly to provide guidance on project direction.”
Co-Creation Workshops
Particularly powerful for user-centered design:
- Design workshops: Multi-stakeholder sessions to define requirements, prioritize features
- Prototype feedback: Structured testing with target users, documented findings
- Implementation planning: Joint sessions addressing barriers, resources, training needs
- Scenario building: Stakeholders develop use cases and adoption pathways
Keys to credibility:
- Specify participant numbers, selection criteria, facilitation methods
- Describe how outputs influence project
- Budget for participant time
- Plan for 2-3 iterations showing responsive design
User Testing and Validation
Systematic validation with target users:
- Alpha testing: Small group of sophisticated users, structured feedback
- Beta testing: Broader user group, real-world conditions
- Pilot implementations: Full deployment in controlled settings with evaluation
- Living labs: Real-world testbeds with continuous stakeholder involvement
Community of Practice
Building sustained stakeholder communities:
- Online platforms for ongoing exchange
- Regular webinars or seminars (monthly or quarterly)
- Annual conferences bringing together stakeholders
- Working groups on specific themes
- Mentorship programs
Evidence of Engagement in Proposals
Evaluators need proof that your engagement strategy is more than aspiration. Provide:
1. Letters of Support and Commitment
Not generic endorsements, but specific commitments:
- “We commit to providing 30 patient participants for usability testing”
- “Our organization will contribute €50,000 in-kind through staff time”
- “We agree to pilot the resulting intervention in 5 of our facilities”
- “We will designate a senior staff member for quarterly Advisory Board participation”
2. Evidence of Prior Engagement
- Results of preliminary surveys or focus groups
- Documented stakeholder workshops that shaped research questions
- Existing collaborations with these stakeholders
- Advisory Board members already identified and approached
3. Detailed Engagement Plan
Create a stakeholder engagement matrix:
| Stakeholder | Interest | Engagement Method | Frequency |
Responsible Partner |
Success Indicator |
| Patient Organizations | Patient perspectives | Advisory Board, co-design | Quarterly SAB, 3 workshops | WP2 Lead | 90% attendance, feedback incorporated |
| Hospital Administrators | Implementation feasibility | Interviews, workshops | M6, M18, M30 | WP5 Lead | Barriers documented, mitigation plans |
| Regulatory Authority | Compliance pathway | Consultation meetings | M12, M24, M30 | Coordinator | Strategy approved, no issues |
4. Budget Allocation
Dedicate visible budget to stakeholder engagement:
- Advisory Board meetings: travel, accommodation, facilitation
- Workshop organization: venues, catering, materials
- Participant compensation: honoraria, per diems
- Communication: platforms, events, materials
- User testing: recruitment, incentives
Typical allocation: 2-5% of total budget
Measuring Stakeholder Engagement Success
Define metrics that demonstrate engagement quality:
Quantitative Indicators
- Advisory Board meeting attendance rates (target: >80%)
- Workshop participant numbers and diversity
- Survey response rates
- Website/platform engagement metrics
- Co-authored publications with stakeholders
- Pilot site participation rates
Qualitative Indicators
- Documented influence on project decisions
- Stakeholder satisfaction surveys
- Case studies of stakeholder contribution
- Testimonials on engagement value
- Evidence of stakeholder ownership
Impact Indicators
- Accelerated adoption
- Stakeholder-led dissemination
- Follow-on collaborations secured
- Policy citations attributed to stakeholder advocacy
- Commercial partnerships emerging
Common Pitfalls and How to Avoid Them
Pitfall 1: Tokenism
Problem: Including stakeholders superficially without genuine influence Solution: Document specific examples where stakeholder input changed project direction
Pitfall 2: Late Engagement
Problem: Involving stakeholders only for dissemination after research complete Solution: Front-load engagement in design phase. Co-create research questions
Pitfall 3: One-Size-Fits-All
Problem: Same engagement method for all stakeholder types Solution: Differentiate approaches based on power-interest matrix
Pitfall 4: Lack of Resources
Problem: Ambitious engagement plan with no dedicated budget Solution: Budget realistically. Designate specific staff for coordination
Pitfall 5: Unrealistic Expectations
Problem: Expecting busy professionals to donate extensive time Solution: Respect stakeholder time. Provide honoraria where appropriate
Pitfall 6: No Sustainability Plan
Problem: Engagement infrastructure disappears when funding ends Solution: Design communities that outlive the project
Pitfall 7: Insufficient Diversity
Problem: Stakeholders dominated by usual suspects Solution: Actively recruit diverse perspectives. Address barriers to participation
Special Considerations for Different Research Types
Clinical/Health Research
- Patient and Public Involvement (PPI) essential
- Ethical considerations and informed consent
- Diversity imperative in patient representatives
- Appropriate compensation for patient time
Technology/Innovation Research
- Balance IP protection with collaborative development
- User-centered design throughout
- Identify and engage early adopters
- Early regulatory engagement
Policy/Social Science Research
- Multi-level engagement (local, national, international)
- Timing sensitivity with policy windows
- Evidence synthesis for policy consumption
- Partner with advocacy organizations
Environmental/Sustainability Research
- Community engagement with affected populations
- Multi-stakeholder platforms
- Long-term relationship building
- Participatory methods and citizen science
Digital Tools Supporting Stakeholder Engagement
| Tool Type | Examples | Best For |
| Collaboration Platforms | Microsoft Teams, Slack | Ongoing communication, document sharing |
| Survey Tools | SurveyMonkey, Qualtrics | Feedback collection, needs assessment |
| Virtual Meeting | Zoom, Microsoft Teams | Advisory Board meetings, workshops |
| Co-design Tools | Miro, Mural | Interactive workshops, collaborative design |
| Community Platforms | LinkedIn Groups, Discourse | Communities of practice |
| Project Websites | WordPress, Webflow | Public updates, resource sharing |
The Horizon Europe Context
Horizon Europe explicitly elevates stakeholder engagement importance:
- Mission-oriented approach: Requires stakeholder involvement in defining challenges
- Open Science: Transparency and inclusive participation
- Citizen engagement: Explicit requirement for participatory approaches
- Impact pathway: Clear articulation of stakeholder contribution
- Ethics and inclusion: Stakeholder diversity assessed
Evaluation Reality: “We assess whether proposals demonstrate genuine stakeholder partnerships or superficial name-dropping. Evidence of prior engagement, specific commitments, and realistic plans distinguish excellent from mediocre proposals. Stakeholder letters that merely say ‘this is interesting’ versus ‘we commit to X’ make a substantial difference in scoring.”
Conclusion: From List to Strategy
Stakeholder engagement transforms from weakness to competitive advantage when treated strategically. The difference lies not in whether you engage stakeholders—every proposal claims to—but in how you demonstrate:
- Systematic planning: Who, what, when, why, how—with specificity
- Prior commitment: Evidence that stakeholders are already invested
- Appropriate methods: Engagement intensity matching stakeholder roles
- Genuine influence: Stakeholders shape research, not just receive updates
- Adequate resourcing: Budget and personnel allocated
- Measurable quality: Metrics for assessing effectiveness
- Sustainability: Mechanisms persisting beyond funding
Projects that excel in stakeholder engagement don’t just score better—they produce more relevant research, achieve faster adoption, generate greater impact, and create lasting partnerships.
Strategic Takeaway: Your stakeholder section shouldn’t read like a list or an afterthought—it should read like evidence that your project is already a partnership before funding arrives. Evaluators fund projects, but they fund partnerships with confidence. Show them yours is real.
In an era where impact matters as much as excellence, stakeholder engagement capability may be the differentiator between projects that get funded and projects that change the world. The choice is yours: check the box, or build the bridges.
